Suitland High School

Suitland design illustration

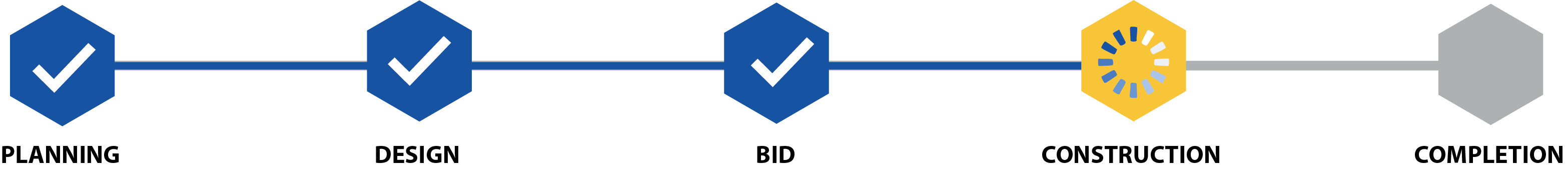

Status
Construction
Funding Model
Staged Renovation
Project Type
Replacement
Budget
$335,000,000
Architect
Cox Graae + Spack Architects
General Contractor
Tuner-Corenic Construction Joint Venture
Project Manager
Sean Nickols



School Information

Principal
Ronald Hollis
Address
5200 Silver Hill Road, Suitland, MD 20747
Neighborhood
Suitland, Arnold Heights
School Board District
District 7
County Council District
District 7
State Legislative District
District 25

Project Timeline

Project Scope

Full Replacement of the existing 344,875 SF and 2,477 student Suitland High School Campus consisting of Comprehensive High School (CHS), Center for Visual and Performing (CVPA) Arts and Career Technical Education (CTE). The proposed design capacity is 1,500 comprehensive and 500 CVPA students. The new facility will be one new facility with the comprehensive and the CVPA school programs only. The CTE programs will be relocated to Crossland High School for school year 2022 - 2023, which will be designated as the new southern comprehensive CTE school for the county.

News & Announcements

There are currently no announcements for this project.

Project Updates

February 2024

Past Month's Accomplishments

  • Installation of switchgear, duct bank, and vault from transformer area was completed.
  • Setting of transformer pad and transformer was completed.
  • A revised permit was formally issued, providing approval to proceed with the building pad, foundations, and under-slab utilities installation work only.
  • The masonry work for the foundation and stair towers has begun.
  • Pulling of cables for transformers and telecom lines has begun.

February Lookahead

  • Pulling of cables for transformers will be completed.
  • Energizing power (Pepco) will be completed.
  • Foundations and under-slab utilities will be completed.
  • Building pad installation will be substantially completed.
  • Grading of the site to final subgrade will be completed.
  • The gas line installation along the site's East side will begin.
  • Pulling of telecom lines will continue.

November 2023

Past Month's Accomplishments

  • Moving of the Imani Temple sanitary line was completed.
  • A temporary screen and fence were installed.
  • Sediment basin A was completed.
  • Boilers, chiller, and partial AHUs were delivered.
  • The release of the switchgear was completed.

November Lookahead

  • A fine grade permit is expected.
  • Building pad and foundation installation will be completed.
  • Mechanical, electrical, and plumbing work will be completed to support foundation work.
  • Masonry work for the foundation and stair towers will be completed.

Documents & Presentations

Live Construction Camera 1  Live Construction Camera 2

Project Update Meeting - 04/02/2024 | Recording; Presentation (English, Spanish, French); Q&A (English, Spanish, French)

Project Update Meeting - 10/25/2023 | Recording; Presentation (English, Spanish, French); Q&A (English, Spanish, French)

Project Update Meeting - 06/05/2023 | Recording; Presentation (English, Spanish, French); Q&A (English, Spanish, French)

Construction Update Meeting - 12/07/2022 | Recording; Presentation (English, Spanish, French); Q&A (English, Spanish, French)

Design and Construction Town Hall - 04/05/2022 | Recording; Presentation (English, Spanish, French); Q&A (English, Spanish, French)

Schematic Design Summary - 10/28/2020 | Summary

Feasibility Study - 03/07/2019 | Feasibility Study

Suitland CVPA Options Analysis - 04/05/2017 | BrochureFinal Report
